MV Freshwater's 2015 Garden Island Dry Docking in Pictures (Part 2 of 3)

Click on each image to automatically advance to the next one

MV Freshwater 2015 Image 51

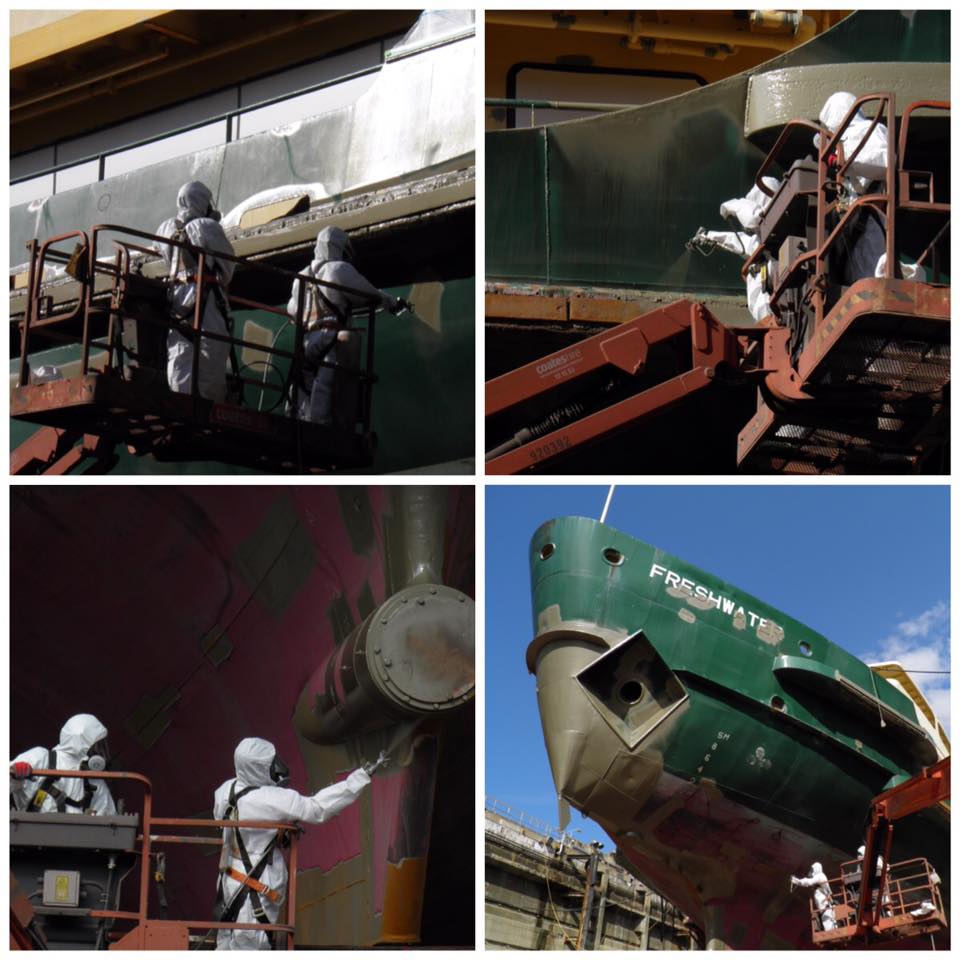

Base coating begins on Freshwater's hull. The painter's spray gun is rarely idle as the skilled lift driver keeps the gondola moving into unpainted territory. Spray teams are working at both ends of the hull, and the up-and-down and side-to-side movement of the gondolas is almost robotic.

MV Freshwater 2015 Image 52

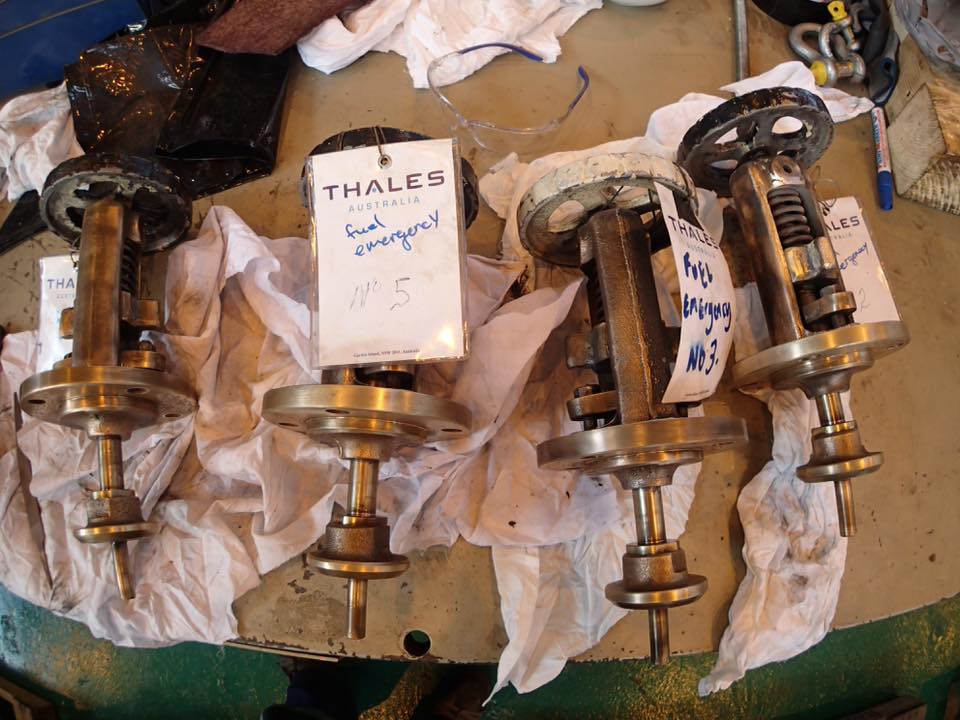

Emergency fuel shutoff valves all under overhaul down to the brass, now being reassembled and readied for testing. These unique valves permit fuel supply to our engines and generator but are designed to be closed instantly, both locally and from remote locations, in an emergency. One of the many types of tests that will have to carried out on our valves before we accept them back into service from the fitters.

MV Freshwater 2015 Image 53

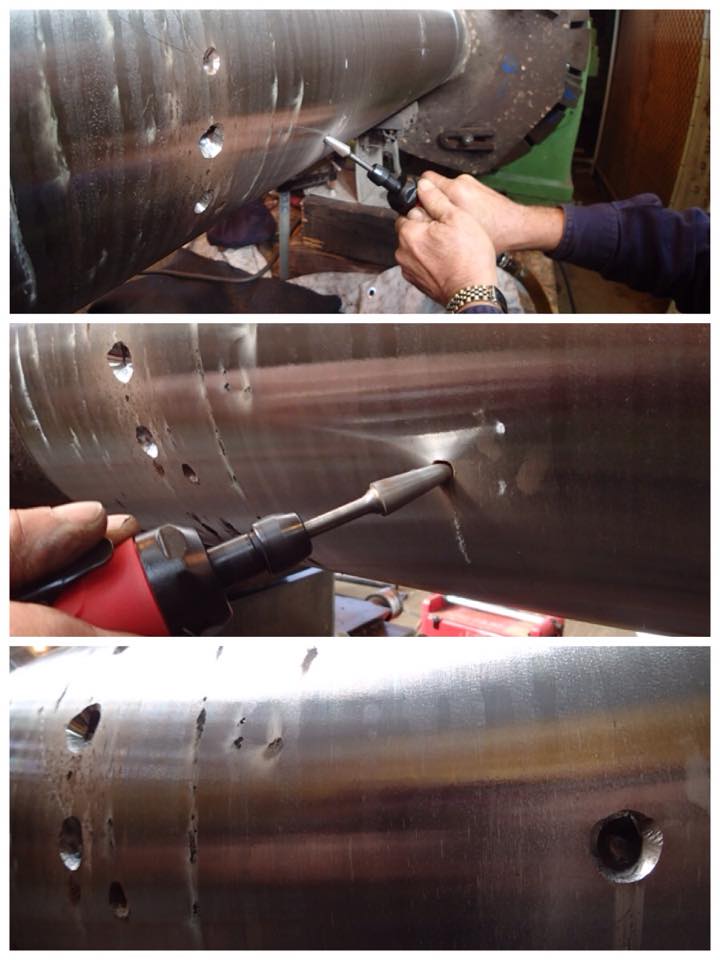

Now it really starts to look like dentistry. Every corrosive pit in the Freshwater's rudder stock has to be gouged out, down to clean metal.

MV Freshwater 2015 Image 54

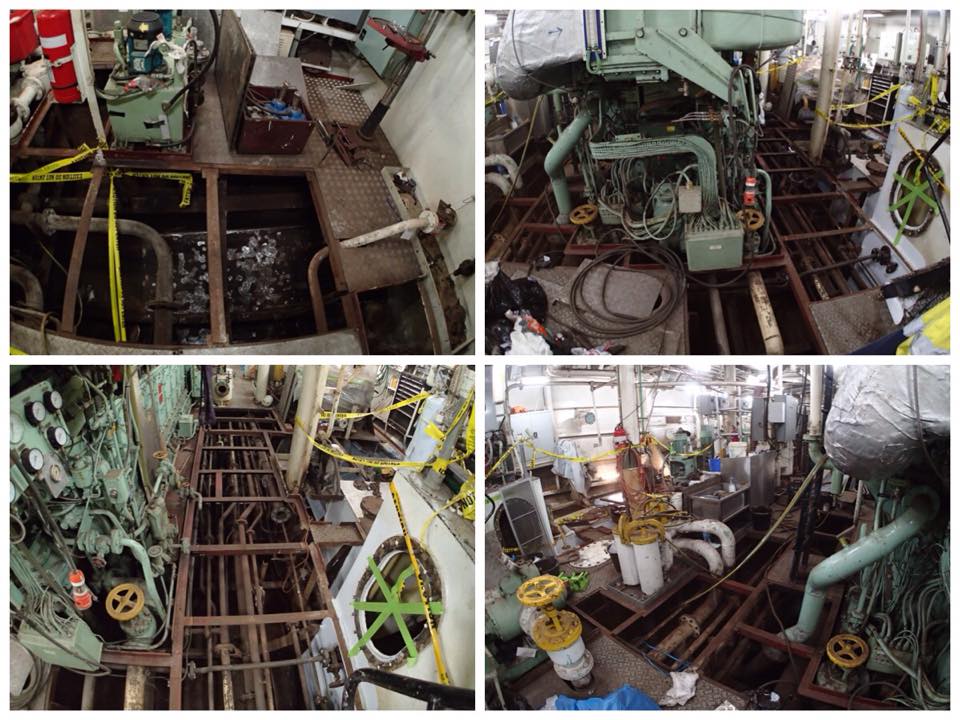

Freshwater's engine room is in total refit mode. Nearly all of the deck plating is removed to allow for cleaning and painting of the bilges. Some areas require serious attention!

MV Freshwater 2015 Image 55

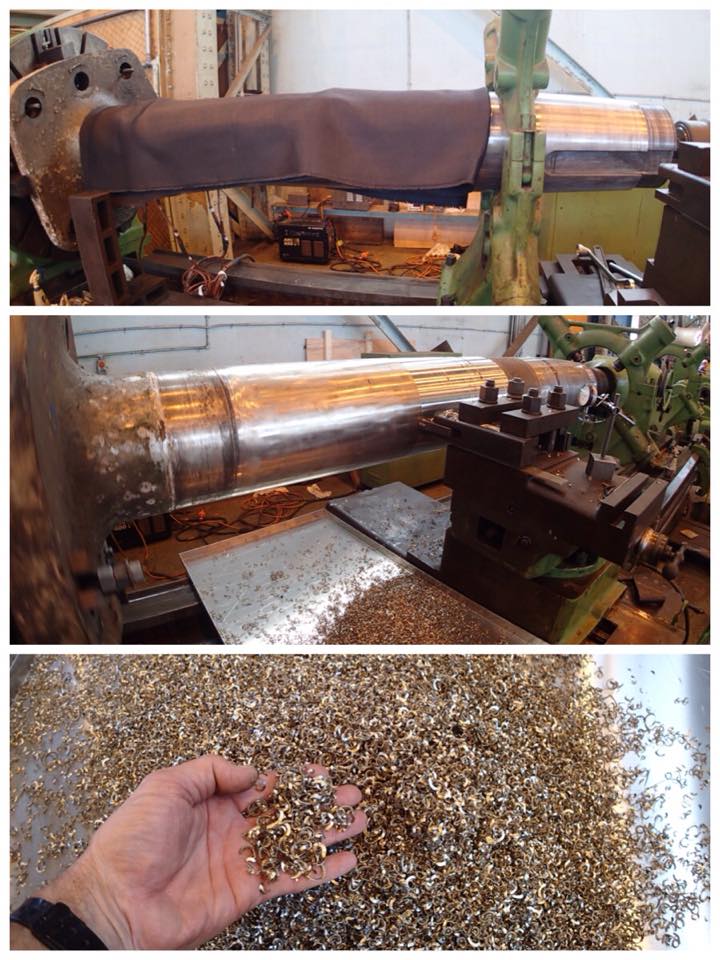

After spending enough time under an electric heating blanket to raise its core temperature to 80C, the rudder stock is then turned on a lathe to take away its outer layer of alloy. One pass takes over five hours and produces a huge pile of shavings.

MV Freshwater 2015 Image 56

Once the "bad spots" have been gouged away, they are backfilled with clean weld. The two fitters work as a team, on opposite sides of shaft, rotating it to weld and then grind. They will do this until all the holes are filled, but they have to stop regularly to slap the heaters back on the shaft to maintain it's 80C core temp. How often is an operation like this performed on a lathe like this? To quote the senior machinist - "Once in a blue moon!"

MV Freshwater 2015 Image 57

The operation to restore Freshwater's forward rudder stock begins with the not-so-simple task of centreing it on the lathe.

MV Freshwater 2015 Image 58

Current state of Freshwater's lower decks. Entire floor surface and nearly all concrete subfloor was broken up and removed. Some exposed steel areas are yet to be treated for rust before pouring of new concrete can begin.

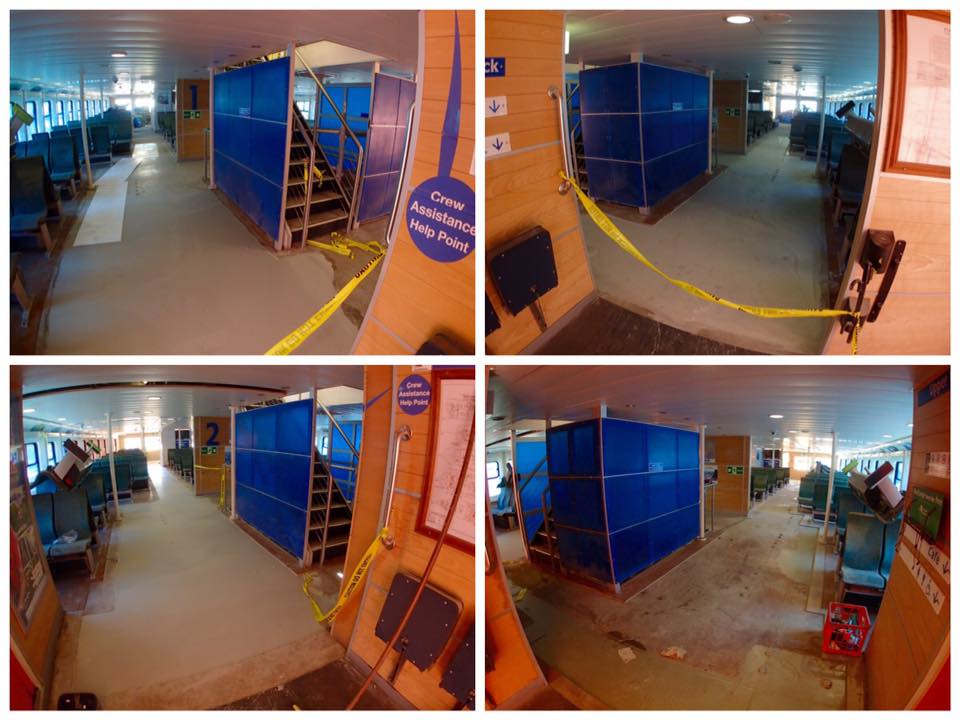

MV Freshwater 2015 Image 59

Current state of Freshwater's upper decks. All major traffic areas have had all the old 2002 cork style flooring and concrete sub flooring removed. Repouring of new concrete sub flooring is underway. New deck surfaces, both upper and lower deck, will be the same dark blue flat material as was installed on the passenger decks of the Narrabeen.

MV Freshwater 2015 Image 60

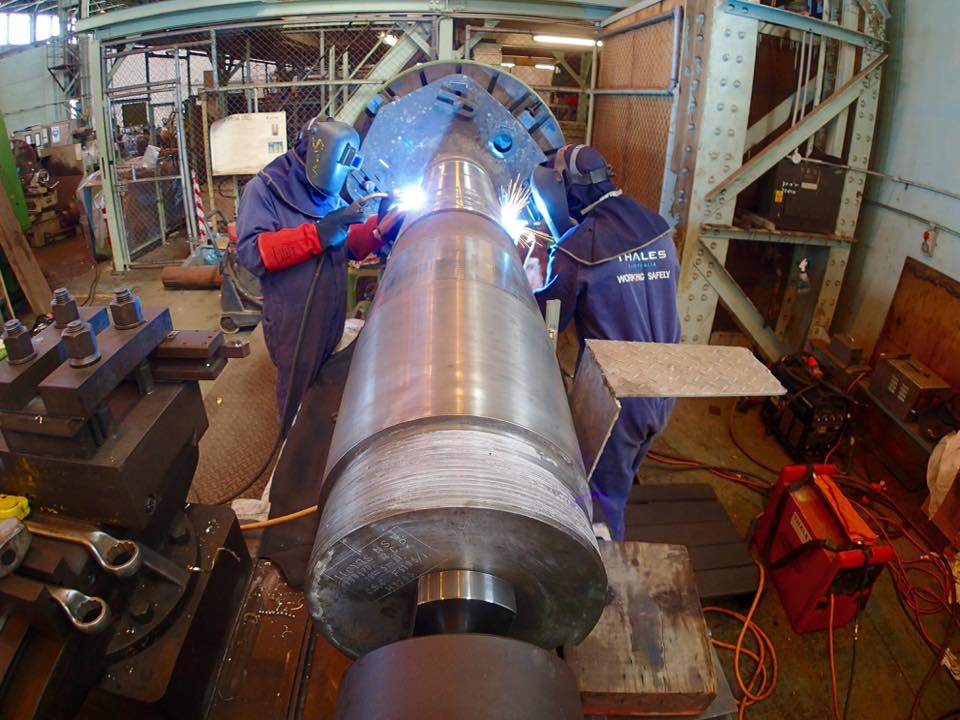

The tandem of welders is busy building back up the surface of Freshwater's forward rudder stock after the surface was machined and all rusted 'cavities' were filled. This highly specialised and unexpected repair will obviously take some time. Note the registration stamp on the top of the stock, in the lower foreground.

MV Freshwater 2015 Image 61

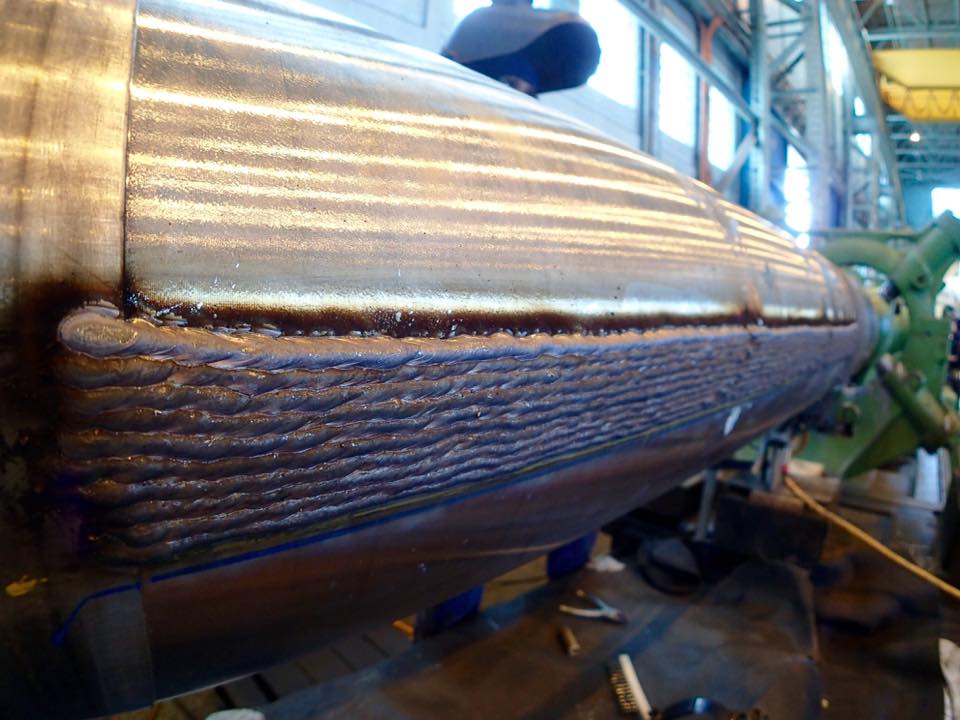

The welders run continuous pools along the entire affected length of the Freshwater's forward rudder stock. They cannot allow the stock to get too hot during the process, so the operation is done in stages.
Once the entire circumference is filled with weld, re-machining will begin.

MV Freshwater 2015 Image 62

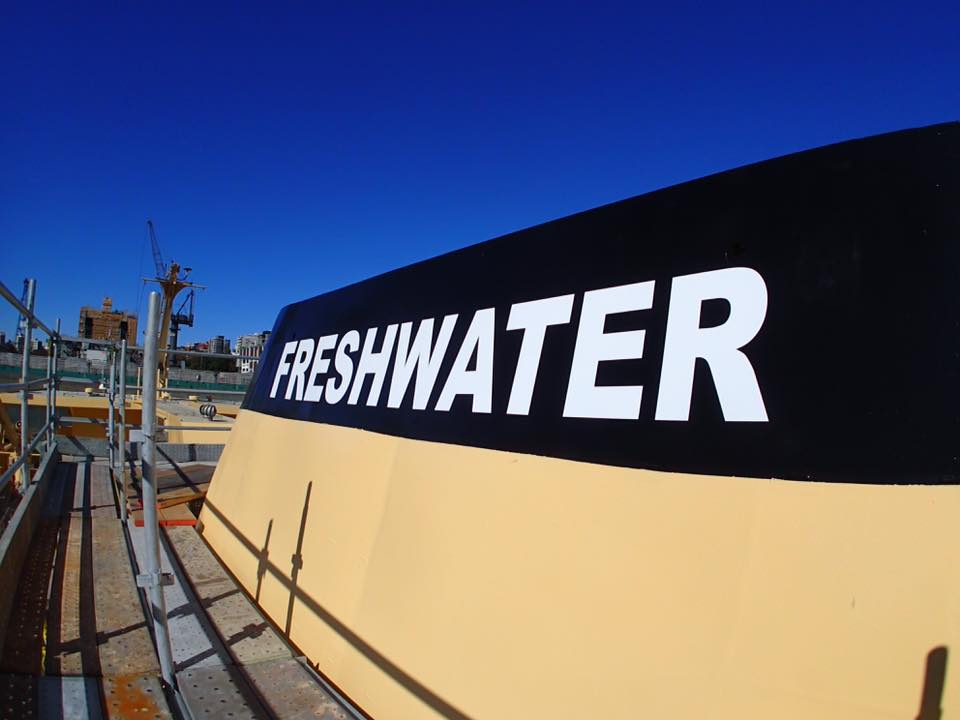

Fresh colour is spreading. New lettering on the funnel!

MV Freshwater 2015 Image 63

We are well past the halfway point now. Re-installation of serviced parts has begun. Here comes Freshwater's aft tail shaft, just before noon on the sundial.

MV Freshwater 2015 Image 64

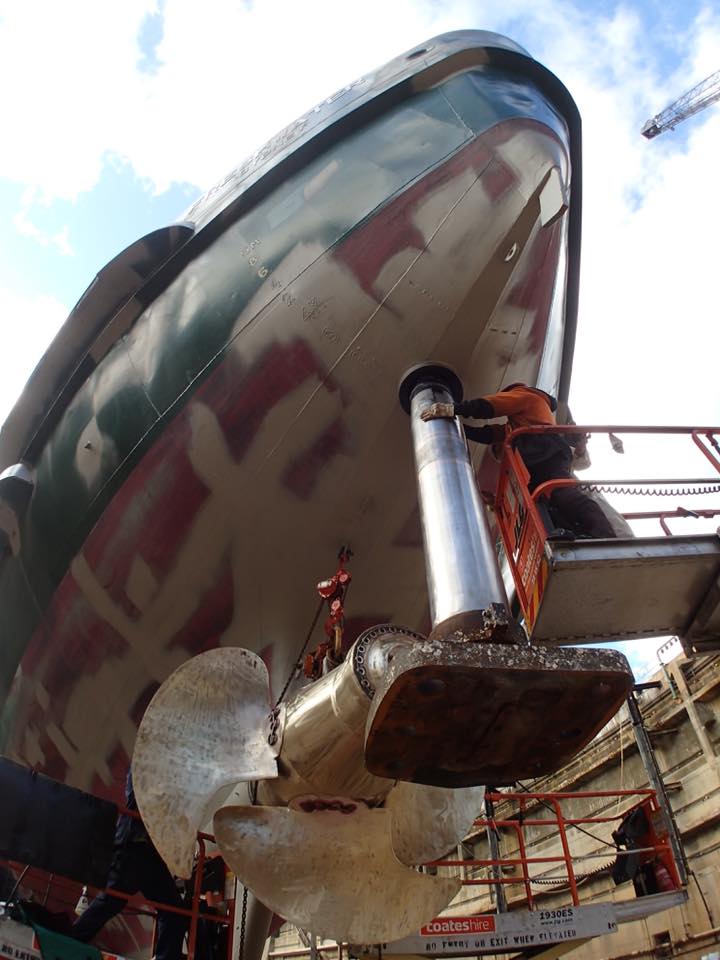

As soon as Freshwater's aft tail shaft was nearly fully housed, the dock riggers forklifted the 2.5 tonne aft rudder stock up into position, and the rigging crew up inside the boat's steering flat took over from there.

MV Freshwater 2015 Image 65

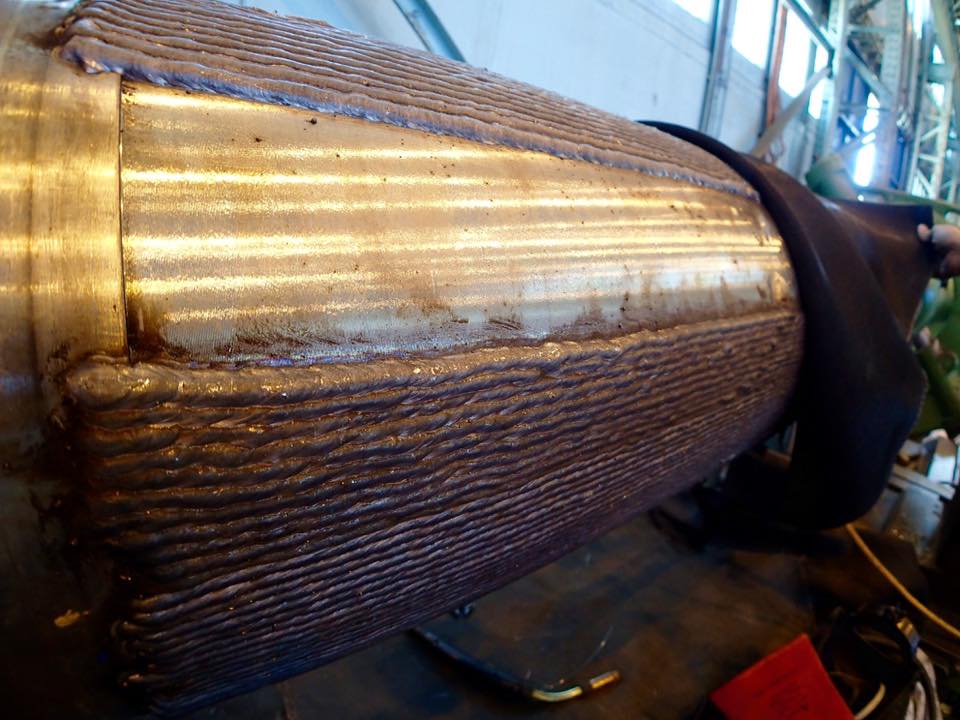

Meanwhile, back in the rigger's shop, repair work progresses on Freshwater's forward rudder stock. Those rows of linear welds are inching closer together. Once they have completely filled the stock's circumference, re-machining can begin. However it is quite probable that the cycle will have to be repeated, either partially or completely.

MV Freshwater 2015 Image 66

The incoming flow of serviced seawater valves has bottlenecked at the entrance down into the engine room. This is the spot where they'll be hooked up to chainblocks and lowered down onto the engine room deck, but right now there is no where to land them while the engine room bilges are being repainted.

Video

Just one complete rotation on the lathe. The Freshwater's forward rudder stock shrouded in 45kg of pure stainless fillet welds. 44kg will probably ultimately be machined back off.

MV Freshwater 2015 Image 68

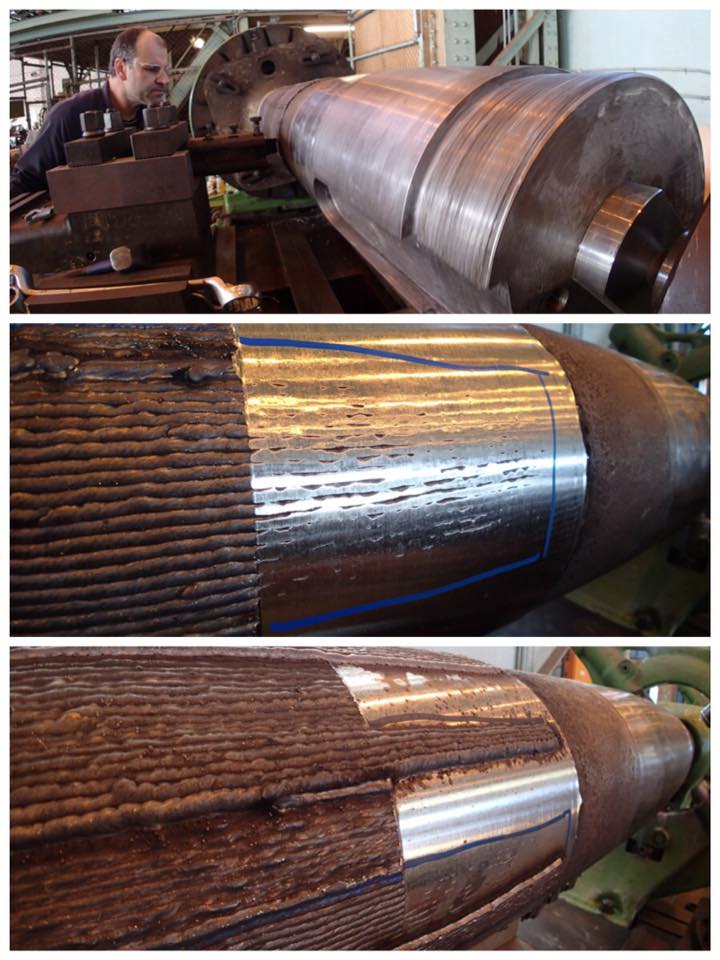

Thirty minutes of re-machining at just one end of the damaged area was all it took. The fitters could then plainly see that a second phase of welding/machining would be required to build up enough shaft diameter. Another 50kgs of rod has been ordered by the foreman and the welders have been at it nonstop since the call was made.

MV Freshwater 2015 Image 69

Freshwater's anchor windlass will be craned back down onto the pedestal today. The anchor pen has been receiving plenty of attention from the painters in preparation.

MV Freshwater 2015 Image 70

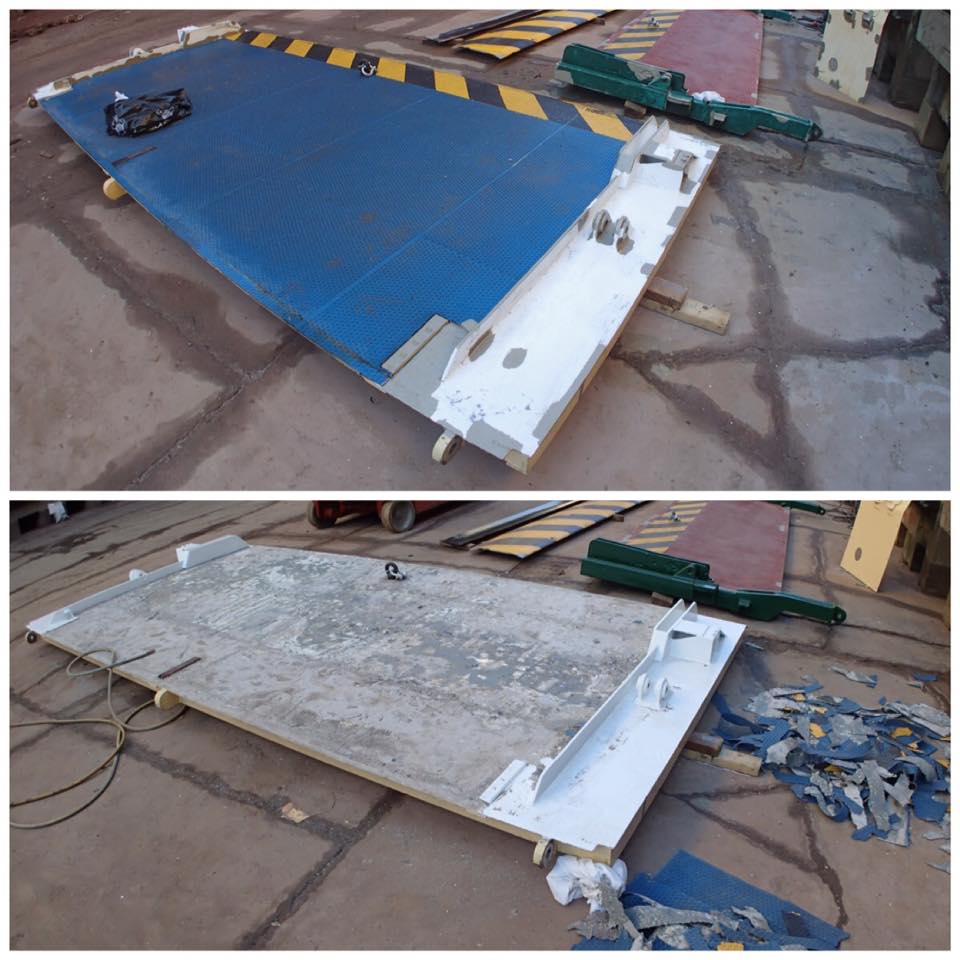

Freshwater's upper deck passenger gangways are aluminium, not steel. Their surfaces are still being stripped back and recoated with a base protection layer before a new anti-slip surface is applied.

MV Freshwater 2015 Image 71

All good at the other end. Freshwater's aft rudder stock is already in position and here go the fitters carrying out the last delicate job of placing the cap back on the steering box. Then they will evenly drive in 120 hex cap securing bolts, all to torque, all by hand.

MV Freshwater 2015 Image 72

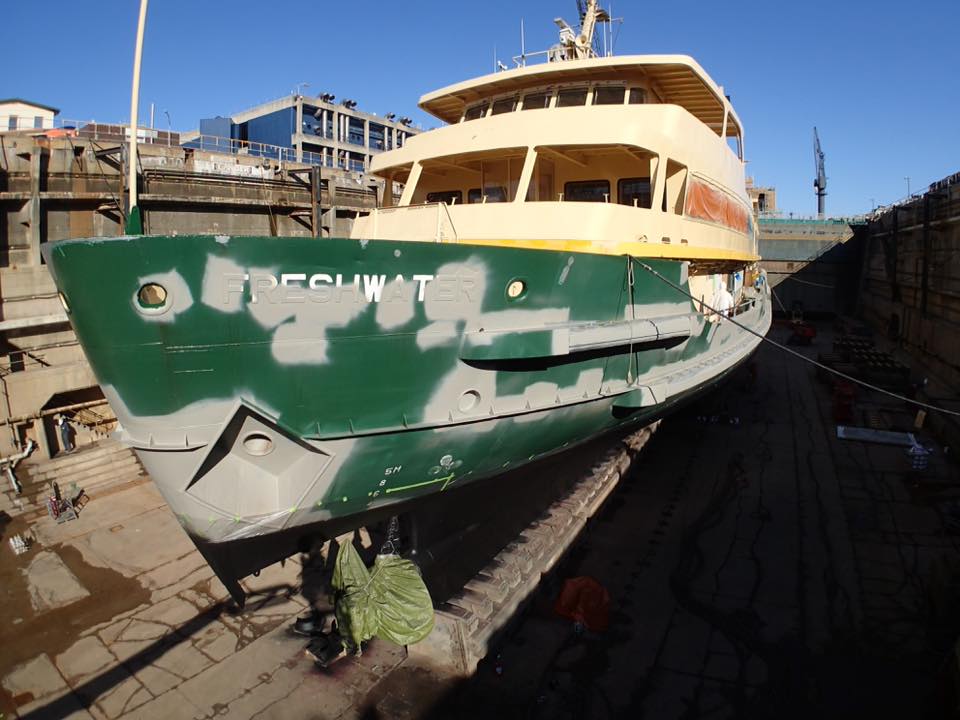

The painters have the best view of the superstructure. The first coat of black anti-fouling paint has been applied to the waterline-and-down hull, while the final patches of primer dot the waterline-and-up green sections. Newly-machined propeller assembly has been wrapped heavily in protective masking.

MV Freshwater 2015 Image 73

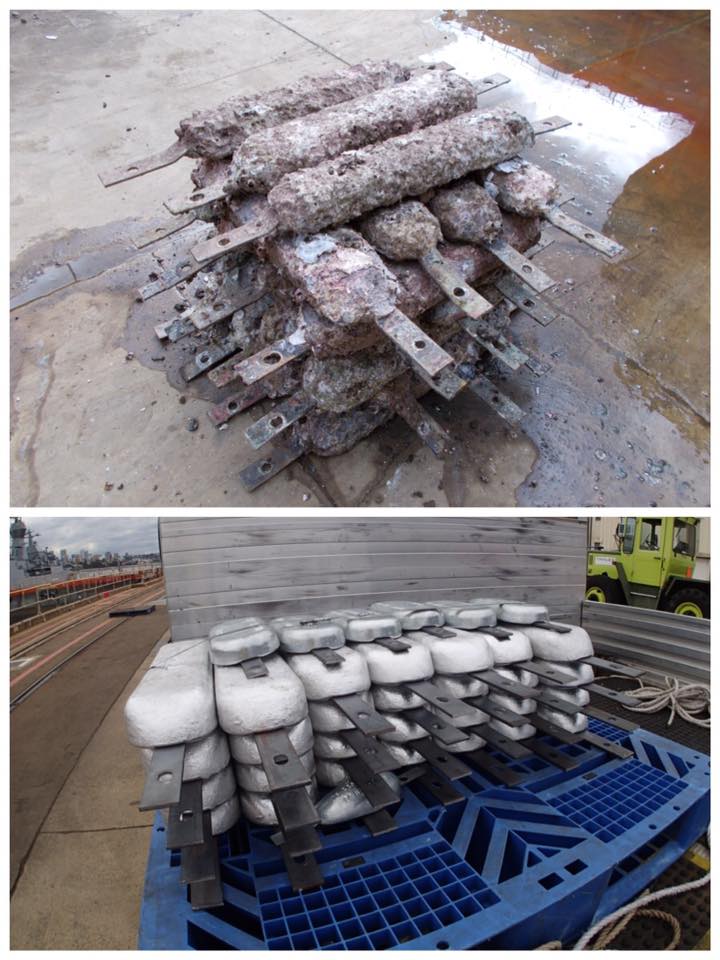

Outgoing old zincs, installed 2010, above. New zincs about to be attached to spend the next five years underwater. If you don't know what these are for, ask a sailor!

MV Freshwater 2015 Image 74

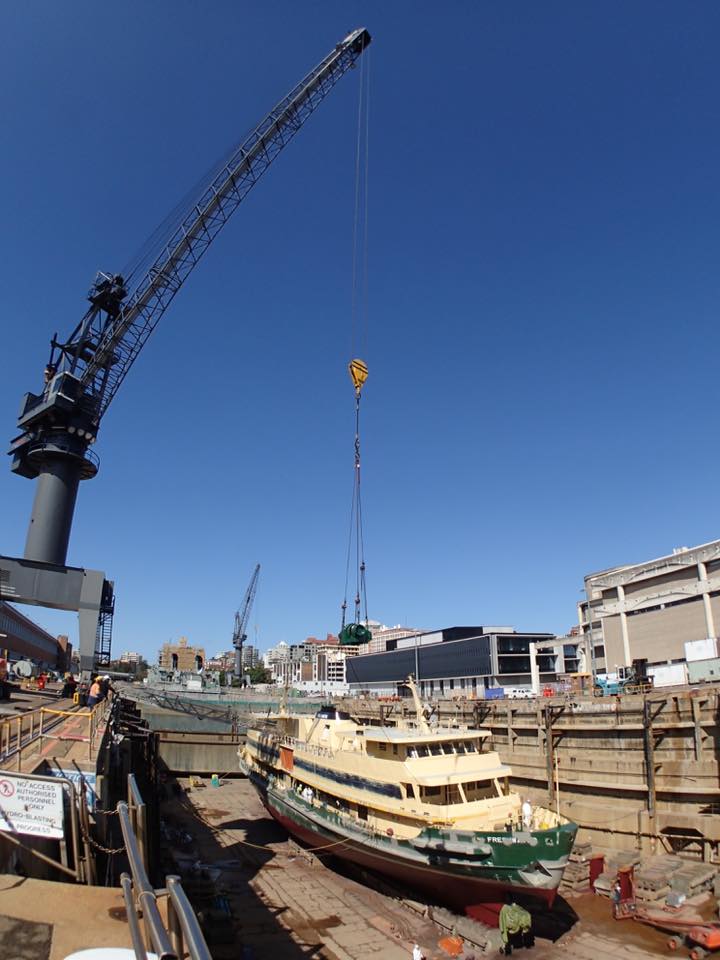

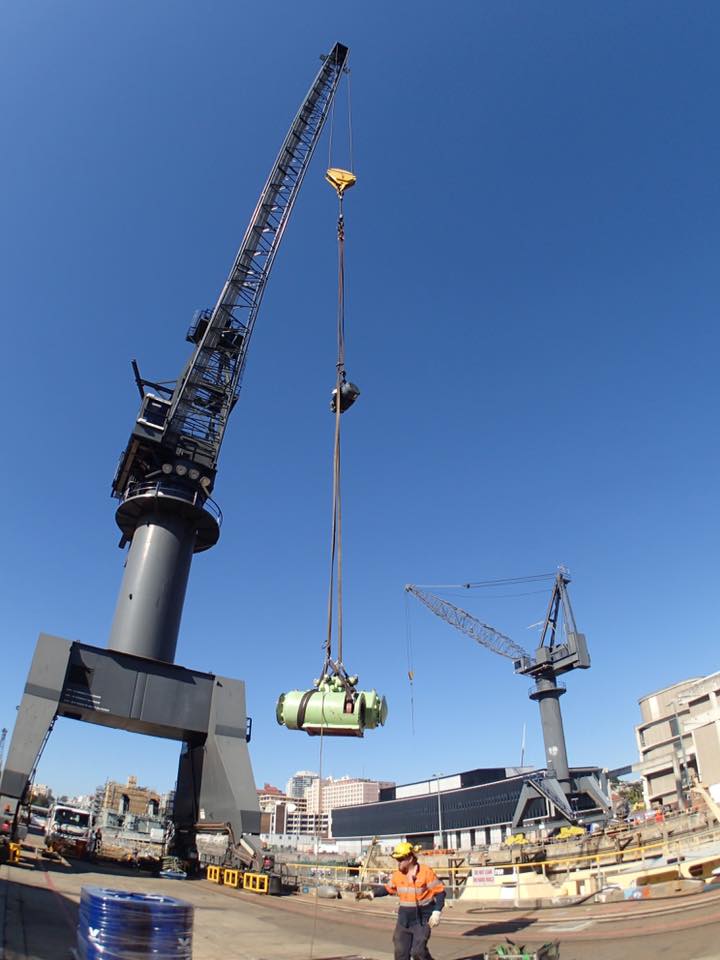

Putting it all back together. The Freshwater's 2-tonne anchor windlass being craned back on board after being overhauled and painted.

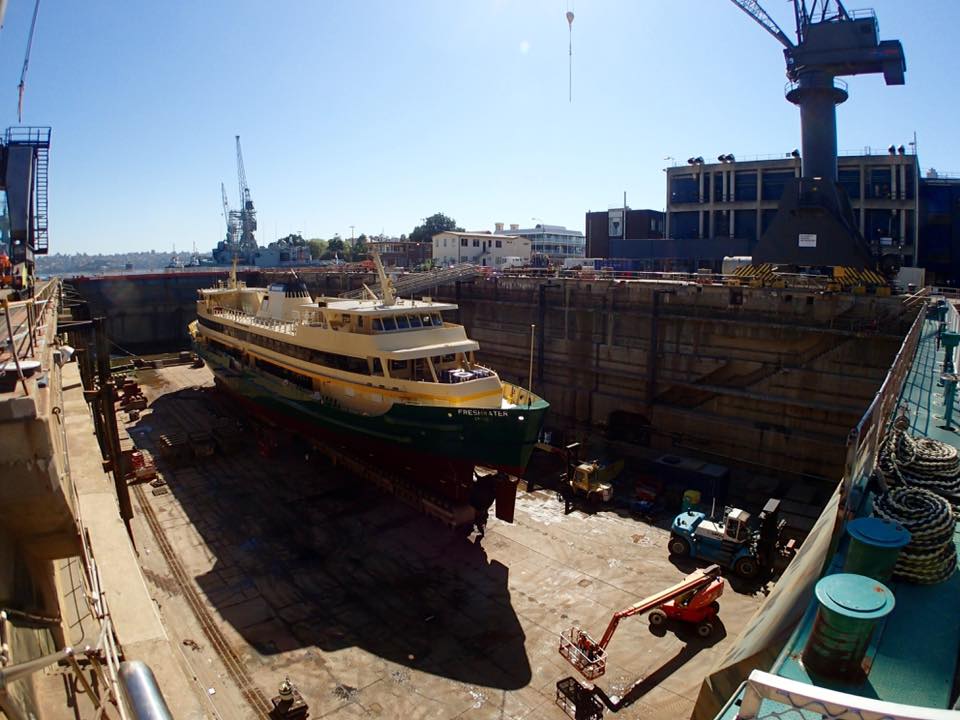

MV Freshwater 2015 Image 75

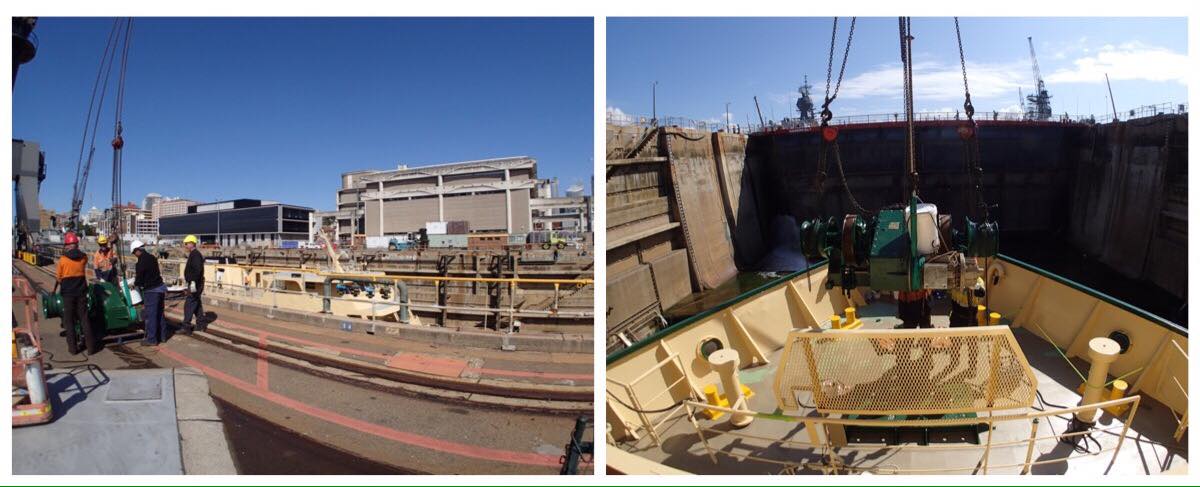

Lifting and landing the windlass is all in the hands of the riggers.

MV Freshwater 2015 Image 76

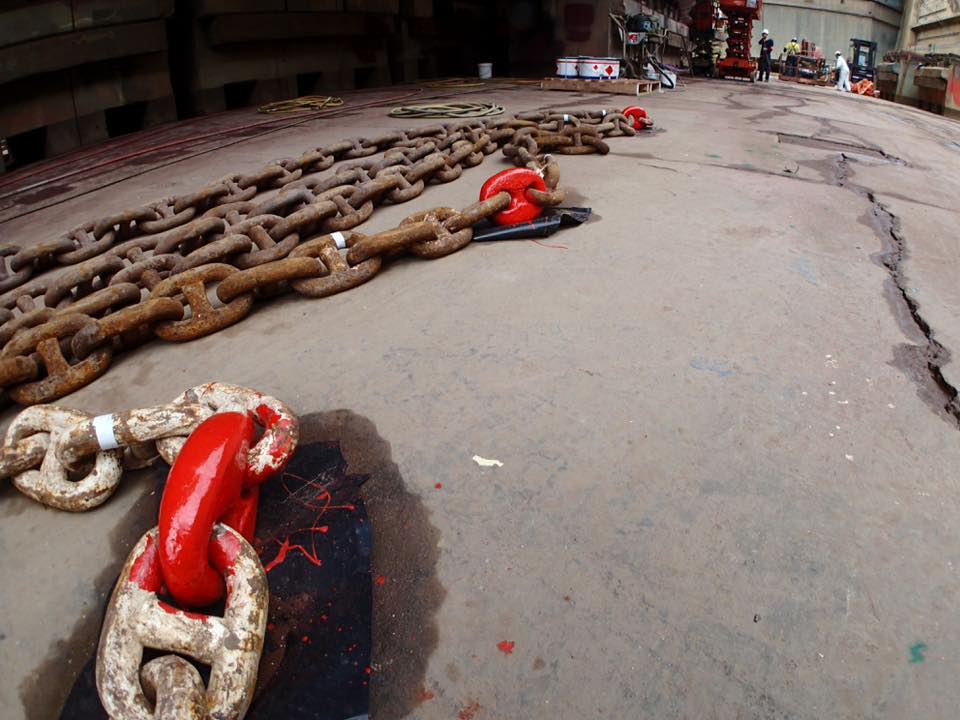

Anchor chain has been surveyed and repaired. Seven shackles per side, all newly marked, ready for loading into the chain lockers tomorrow once the windlass in back in action.

MV Freshwater 2015 Image 77

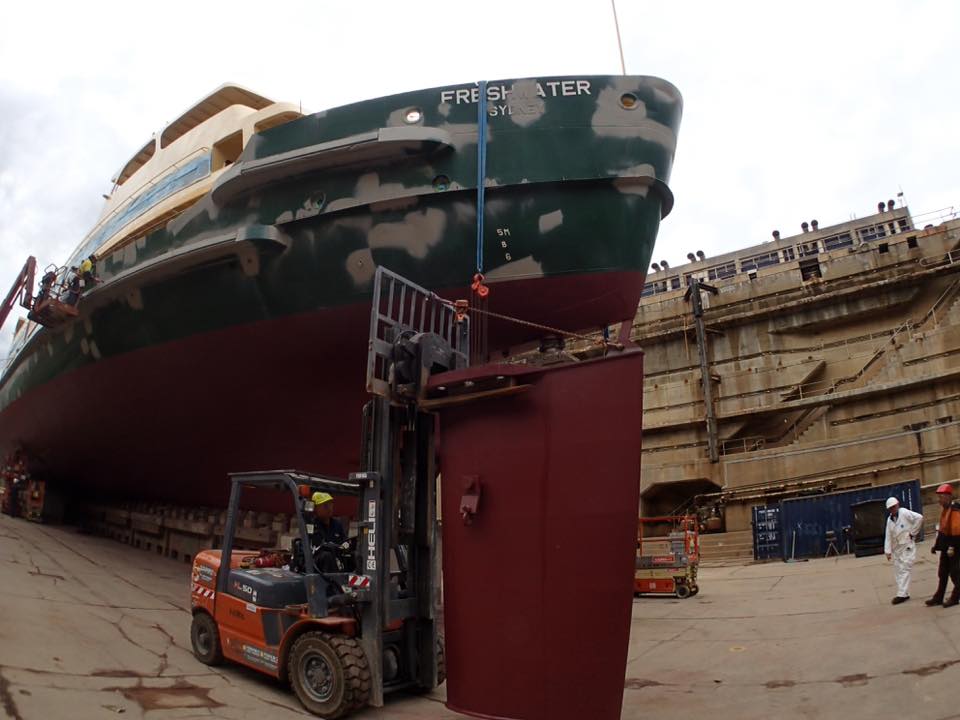

Freshwater's aft rudder arrives by forklift, ready to to be brought up and bolted to the already-in-place aft rudder stock.

MV Freshwater 2015 Image 78

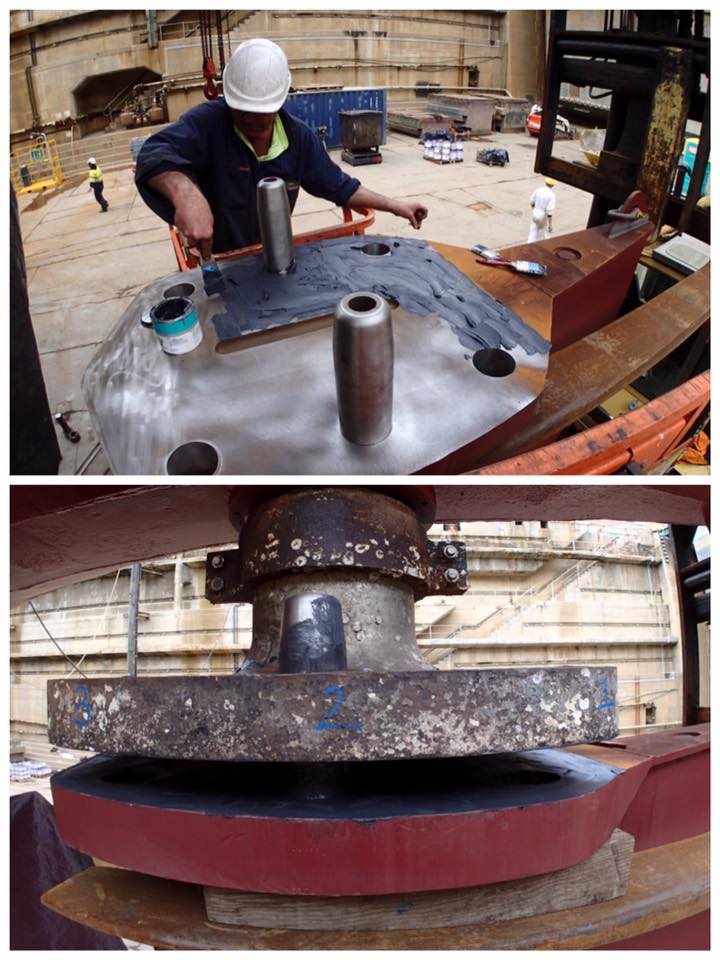

After preparing the mating surfaces properly so they can be easily separated in 2020, the rudder is eased up into the locating pins and joined to the stock. It will then be brought up tight with chain blocks, the two tapered pins will be dropped and the six numbered bolts will be refastened.

MV Freshwater 2015 Image 79

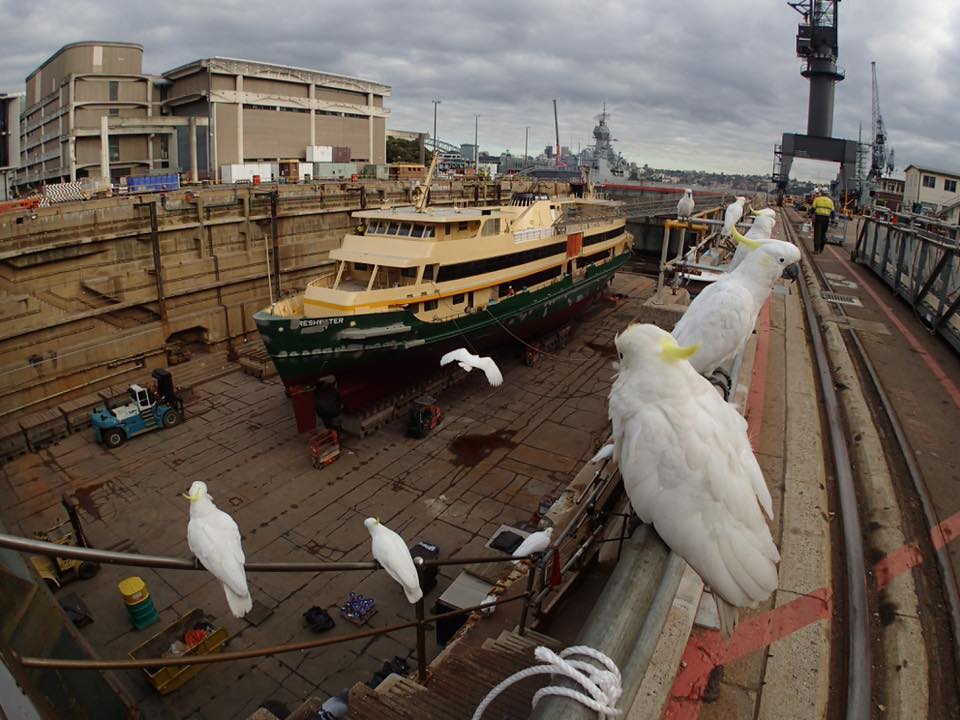

Sulphur Crested Cockatoos perched atop the south end of the dock, swoopingly watching the crews descend down the 76 stone steps each morning. No wonder hard hats are compulsory here. The last of the dark green colour will be rolled on today.

MV Freshwater 2015 Image 80

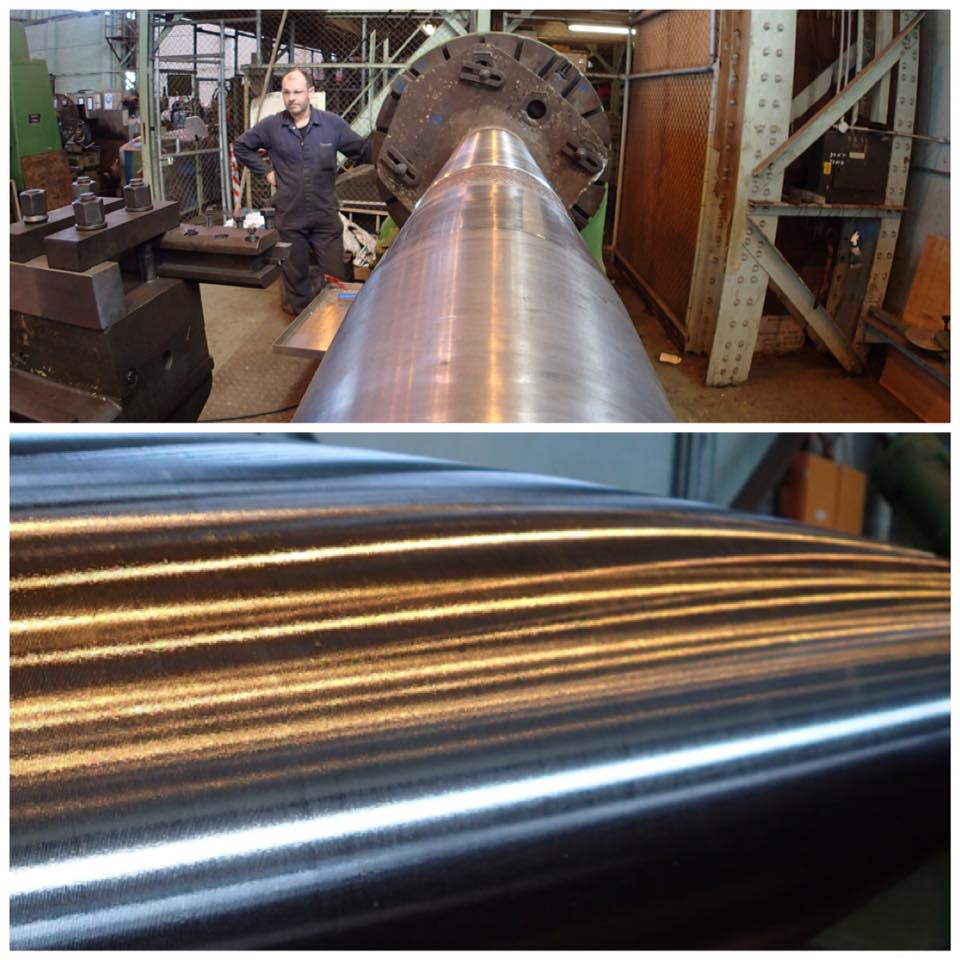

Machinist is satisfied. Surveyors are satisfied. After having over 60kg of stainless rod welded onto it and 80% of that amount machined back off, the Freshwater's forward rudder stock is finally ready to put back into service

MV Freshwater 2015 Image 81

After being slung perfectly flat by the riggers down in the dock, The Freshwater's upper port gangway ramp is craned back up into position and carefully aligned onto its pins.

MV Freshwater 2015 Image 82

The painters are closing in on completing the painting of the hull and superstructure.
Here, the team applies the final strokes of the first coat of "STA Fleet Green" Only the navigation and bridge decks now remain left to paint.

MV Freshwater 2015 Image 83

Now that the final coats of paint on the hull and rudders have set, the new zinc anodes can be affixed. Below the waterline, there are no areas left beyond their protection. A pair of them is bolted to the base of each rudder, and there are a total of 35 spread throughout the hull.

MV Freshwater 2015 Image 84

The last groups of Freshwater's hydraulic steering motors are craned back down onto the vessel's decks, where the riggers and their chainblocks are waiting to carefully walk them back into the tightly confined spaces from which they have all come.

MV Freshwater 2015 Image 85

The Freshwater's shadow will disappear for another five years when we refloat the vessel, probably by Wednesday.

MV Freshwater 2015 Image 86

The crane drivers have to see everything. This should give you a good idea of exactly were we are.

MV Freshwater 2015 Image 87

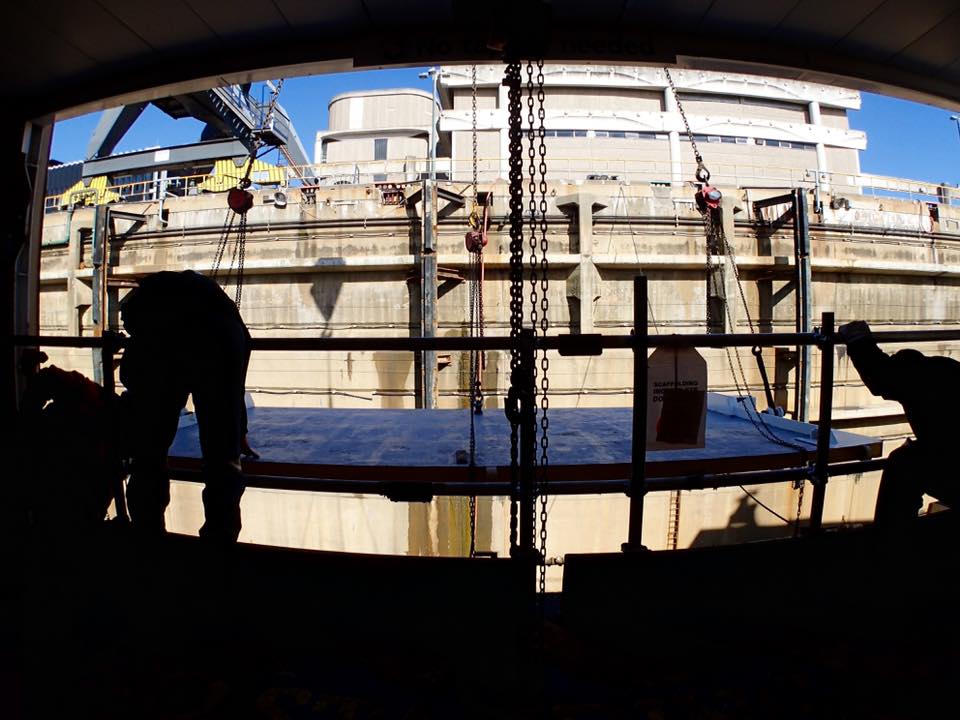

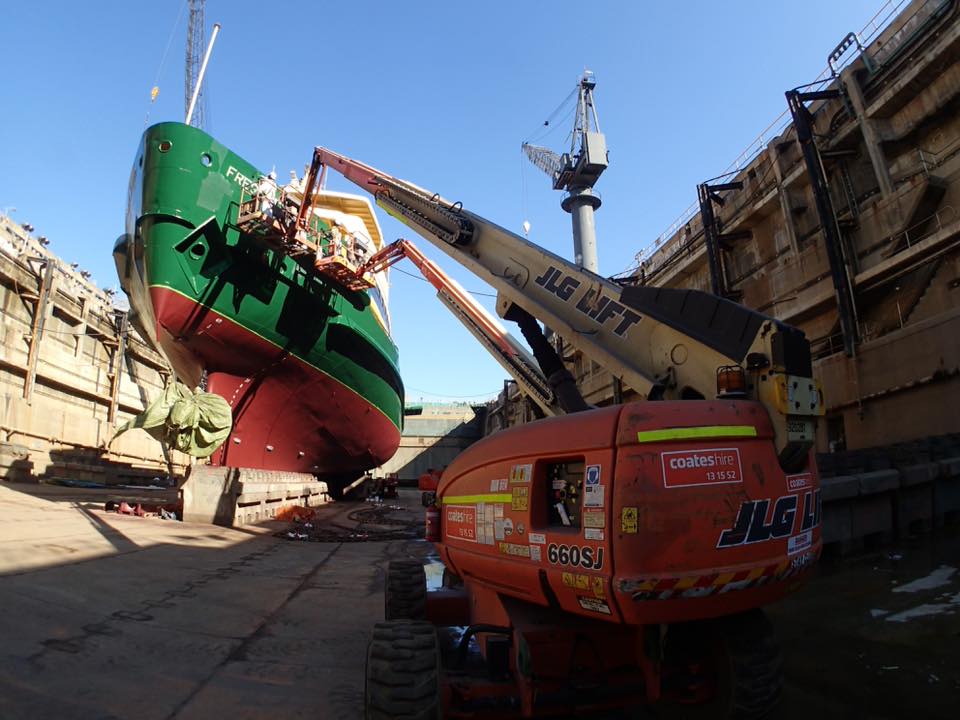

In the hot midday sun, the riggers ease the Freshwater's starboard upper gangway into position.

MV Freshwater 2015 Image 88

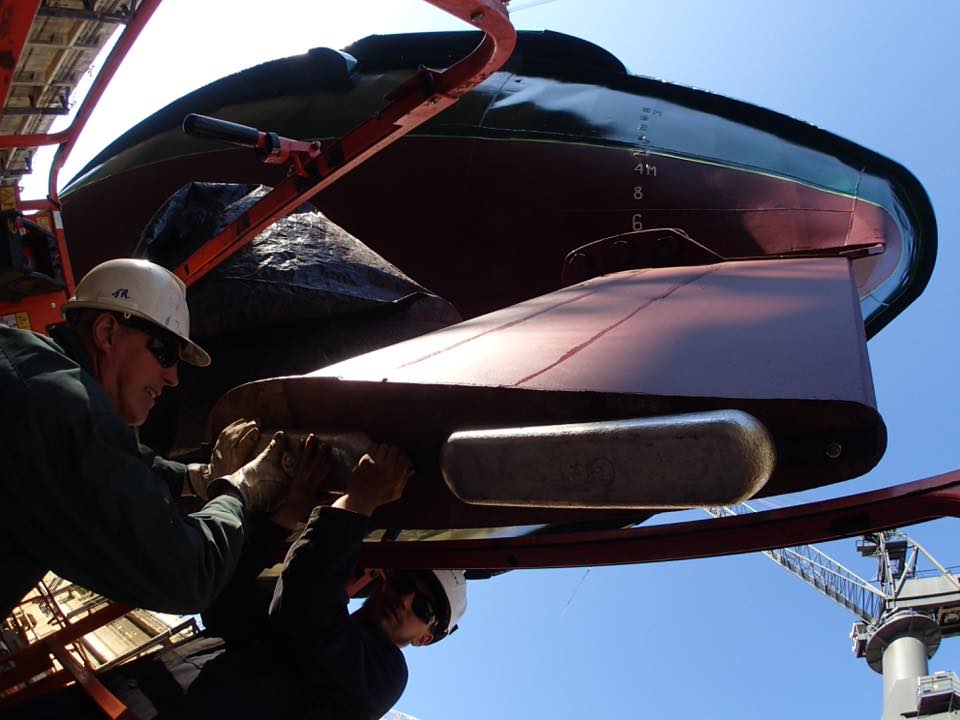

After all the fuss over its repair and recertification, the Freshwater's forward rudder stock finally being craned back into the dock barely seems to make an impression .

MV Freshwater 2015 Image 89

The final few pieces can now be put back into the puzzle. The Freshwater's forward rudder stock sits on the floor of the dock. Today it will be rehoused, and then the rudder will be bolted up onto it once the stock is finally joined into the steering box and tested.

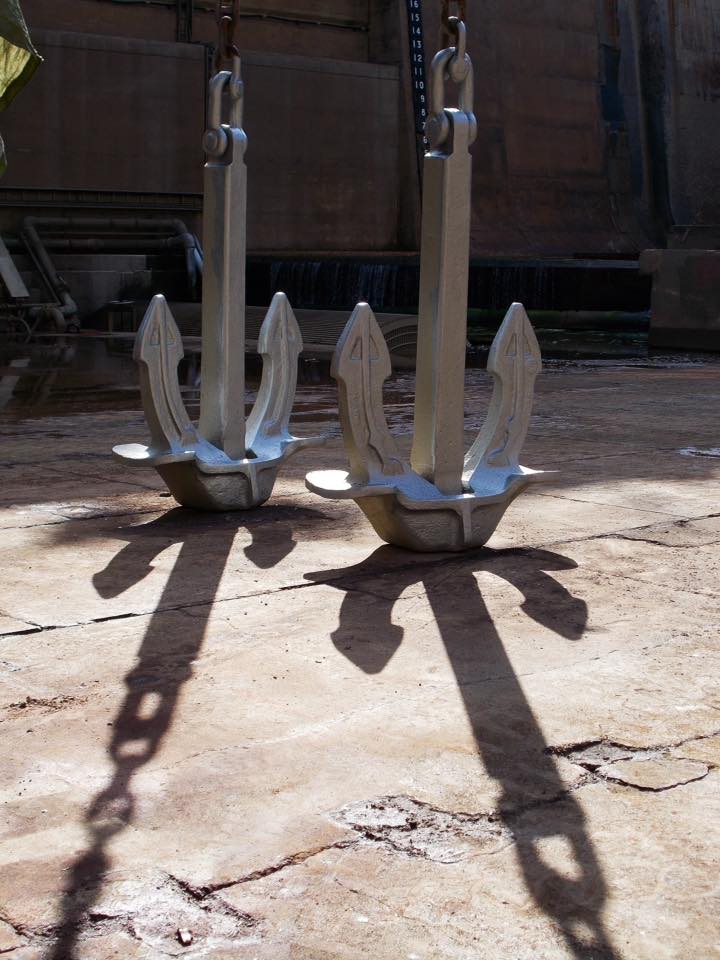

MV Freshwater 2015 Image 90

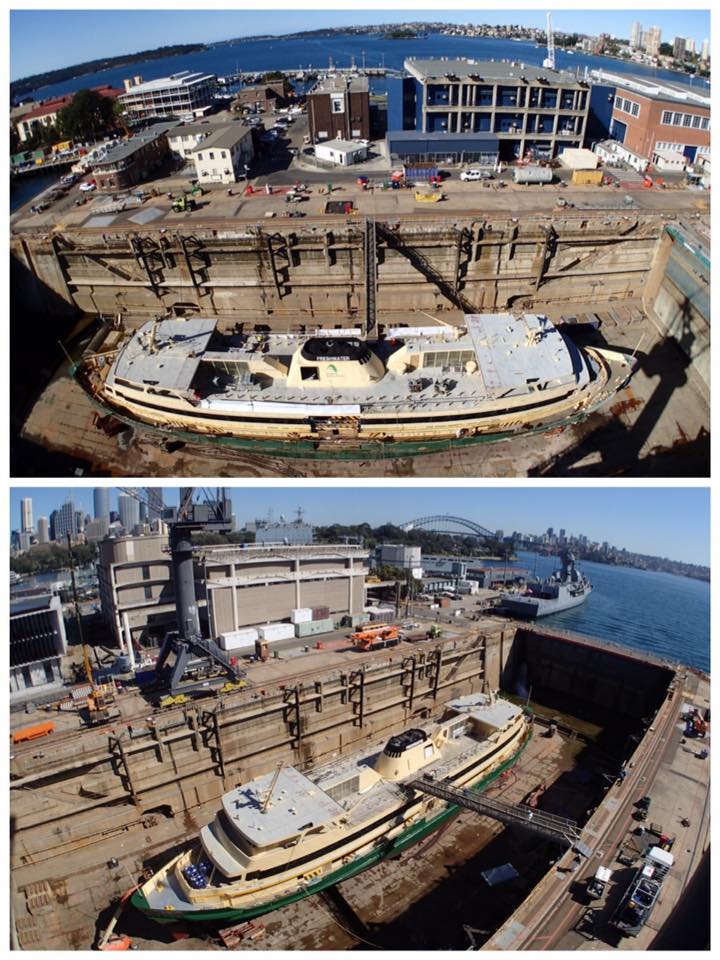

Both lengths of anchor chain have been hauled back up into the chain lockers. Now the anchors are standing tall to await their final prep and paint.

MV Freshwater 2015 Image 91

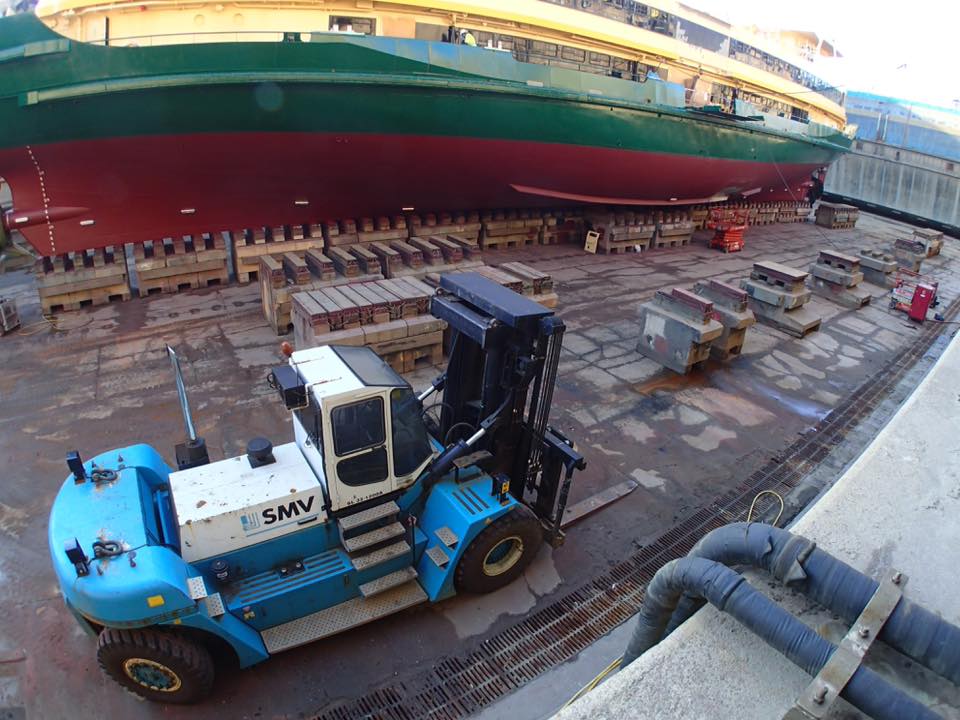

Freshwater begins its final few days on the blocks. The crane dropped this 32-tonne forklift into the dock a few days ago, and since then it has been re-organising the keelblocks around us in preparation for the docking of the next vessel, a dredge with our same length and beam but much heavier than us. We are getting the bum's rush.

MV Freshwater 2015 Image 92

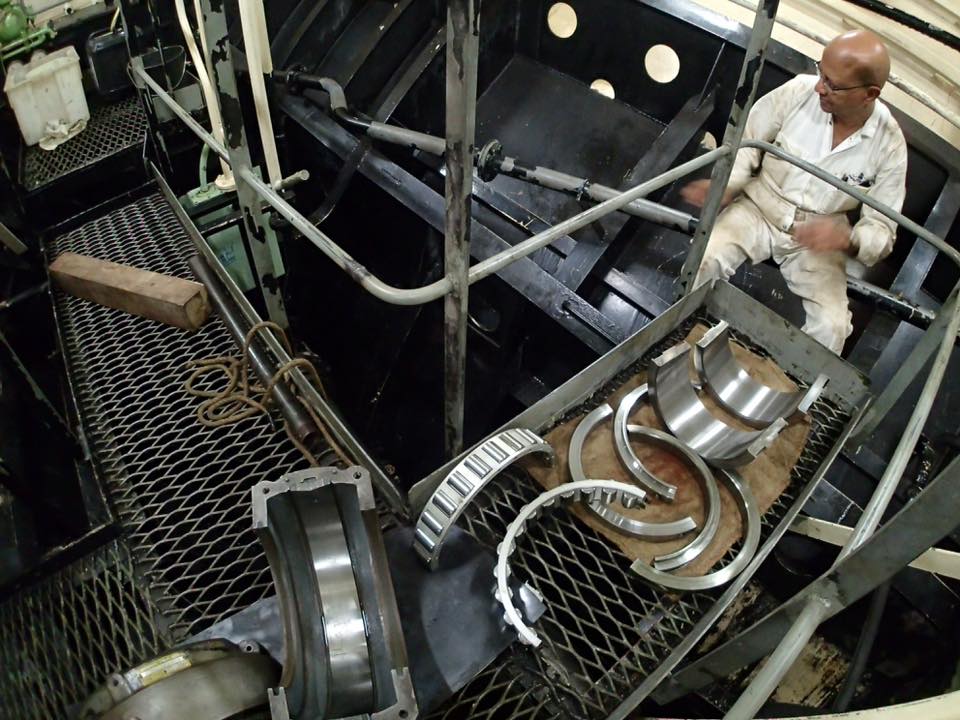

All internal. Servicing one of the ship's ten main shaft bearings. Each of these Cooper Bearings weighs over 40kgs and has to be disassembled into twelve interlocking parts. To service just one of these bearings, half of which are in need of replacement, the fitters temporarily lift the shaft up with a 100-tonne pneumatic jack.

MV Freshwater 2015 Image 93

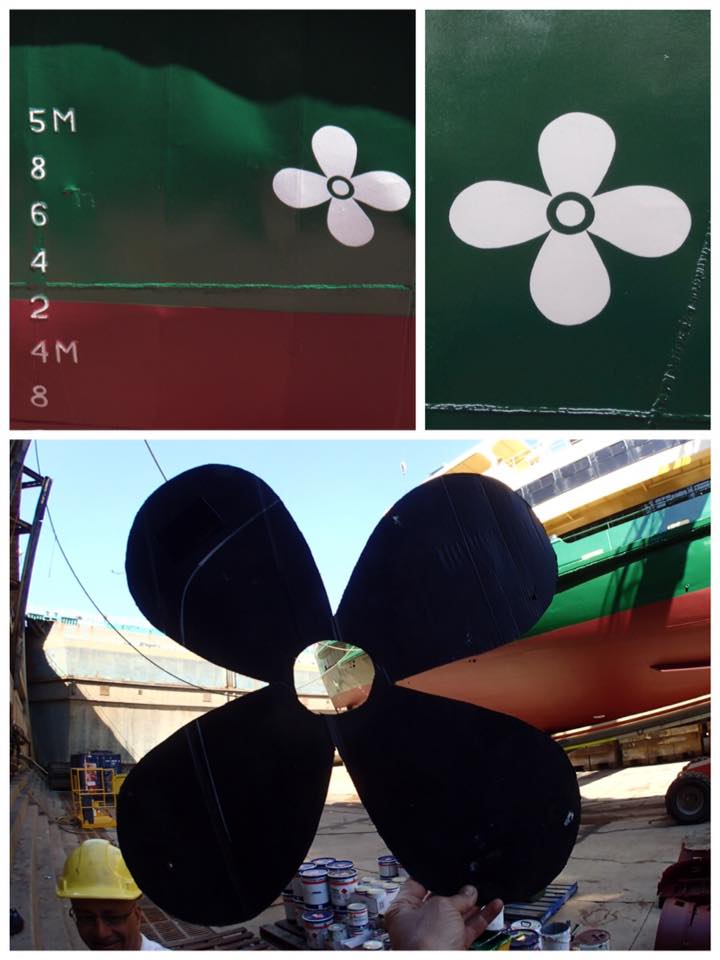

This is how they do it. Even our four propellor icons are done with precision.

MV Freshwater 2015 Image 94

Trying out a new method this time when it comes to painting our decks. Limiting the range of the anti-slip safety grit to only those areas where it is needed, and keeping it away from limber holes and scupper mouths. This will help to more freely allow seawater - and Manly Beach sand - to escape our decks, quickly back over the side.

MV Freshwater 2015 Image 95

The final strokes of the painter's brush.

MV Freshwater 2015 Image 96

These indentations in the ship's rudder are an indication of its internal construction. The rudder is not solid but in fact hollow, and has a cagelike internal 'skeleton' which prevents it from collapsing from the constant pressure of submersion.

MV Freshwater 2015 Image 97

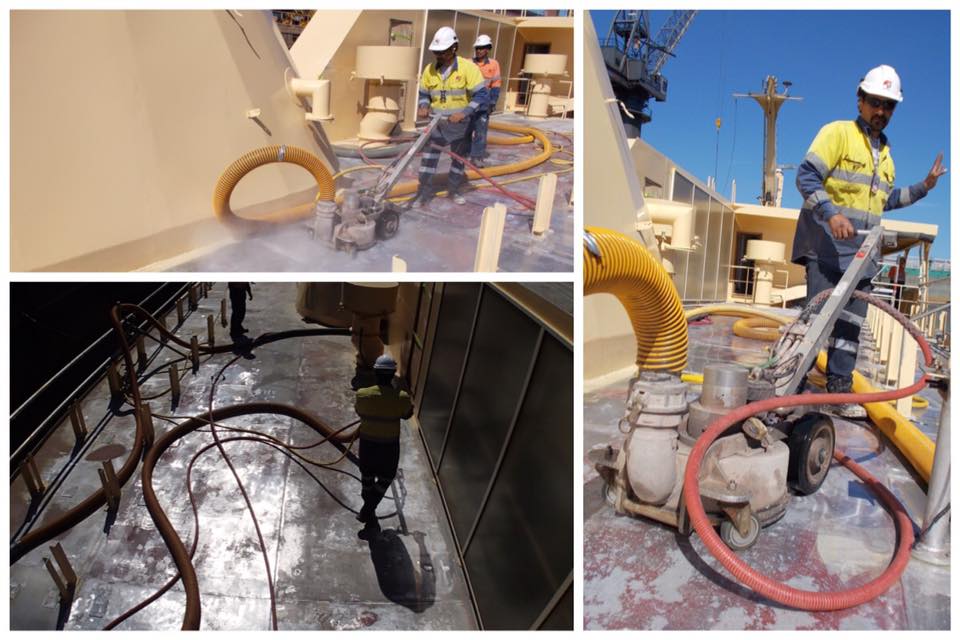

In the boiling hot sun, the final assault of deck surface stripping terror is unleashed upon the Freshwater's navigation and bridge decks. The dreaded orbital suction mower. This savage primate will strip up the entire compliment of the old, degraded zinc chromate surfaces from the decks and take them back to pre-2002 bare aluminium. The key feature of this beast is that it instantly collects and removes all of its own spoil, ensuring that all of the freshly-painted decks and hull directly below are kept free from the ugly, damaging affects of the milky grey runoff.

MV Freshwater 2015 Image 98

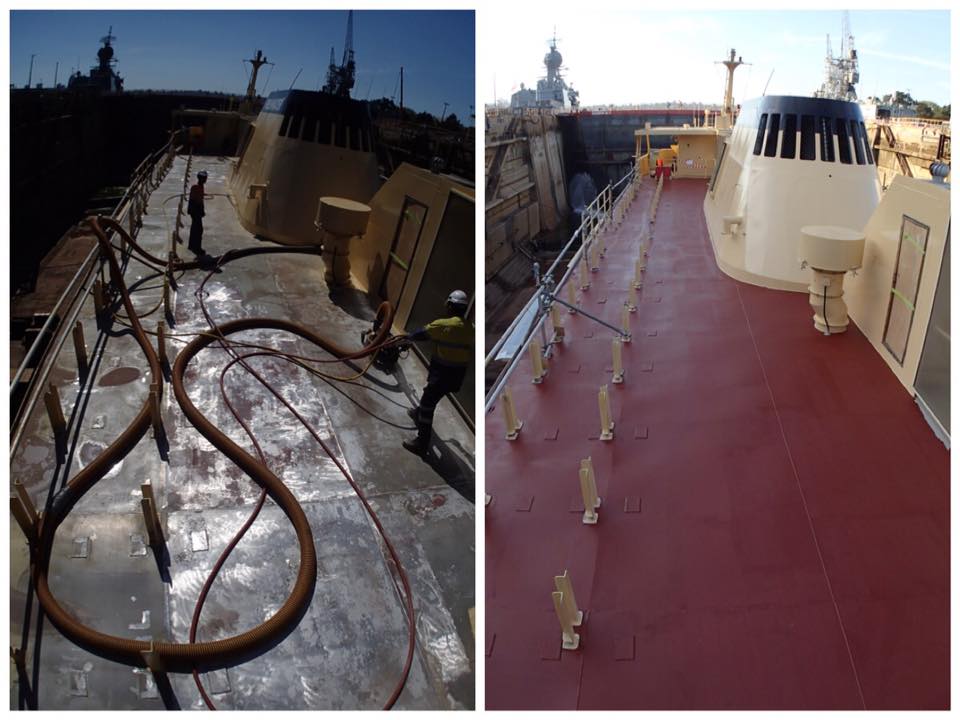

Soon after the fury of the suction mower has passed, the Freshwater's port side navigation deck is blown dry, allowed to sun dry and then roll coated in red-coloured primer.

MV Freshwater 2015 Image 99

A visit from the fleet commodore. Chook Macdonald arrives for a bit of photo documentation

MV Freshwater 2015 Image 100

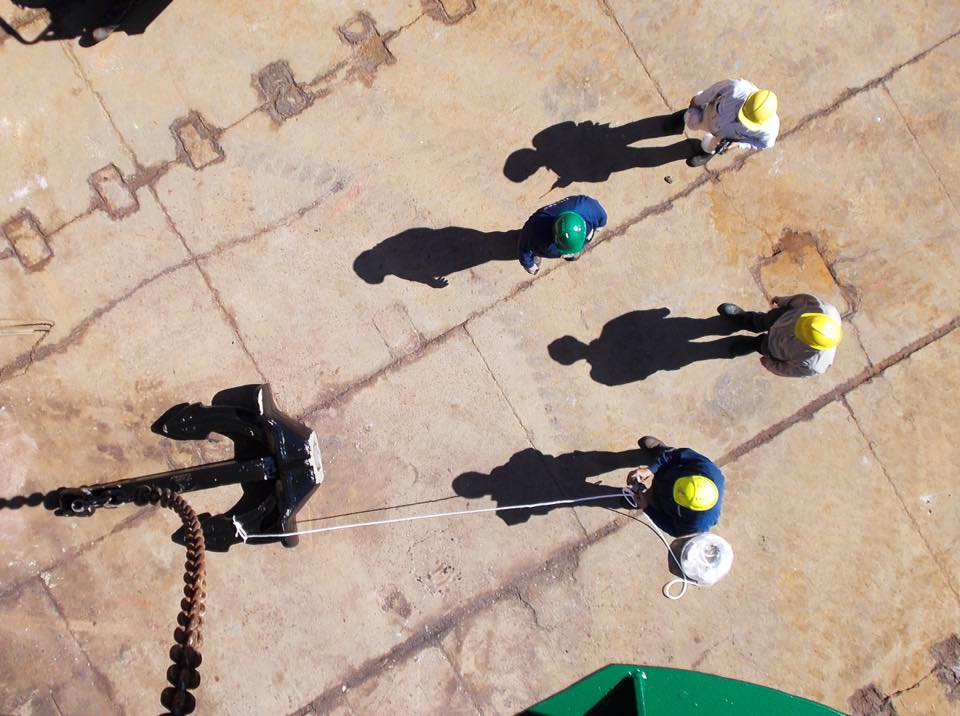

One for the crew. Even when being hauled up from the dock, the Freshwater's port anchor refuses to come up into the pipe properly.
